December 8, 2012

Day 8 - Scheduling Projects with TaskJuggler

This was written by Ben Cotton.

"Ew! Project management?" you say, "that does nothing but get in my way!" But let's face it, most sysadmins don't have a project manager to work with, so they end up being de facto project managers. If you're doing anything beyond daily tasks, you manage projects, whether or not you think of it that way. "Project management for sysadmins" could be a whole book, but for today we'll just consider scheduling. You can try to put together a project schedule yourself, or you can let the computer do that for you. The open source tool TaskJuggler is well-suited for this task.

Unlike other project management tools, TaskJuggler is largely text-based (as of this writing, there is no GUI for version 3). Output is generated with a command line program. This lends it well to working with tools like make, vi, and version control systems.

To get started, install TaskJuggler. Some Linux distributions have a package in the repository, but if your preferred platform (including Windows and Mac OS X) doesn't, you can install it from source or from ruby gems. More information on installation can be found on the TaskJuggler download page. Note that the example used here is done with TaskJugger 3.3.0.

Moving To a New Building

The example we explore today is that of a site move. Sysadvent, Inc. has outgrown its current building and will be moving to a new, shiny tower downtown. Sally Sysadmin is in charge of this project. The move will begin in January and is expected to take three months to complete.

Fortunately, Sally doesn't have to do all the work herself. She has two helpdesk staff, Harry Helpdesk and Henrietta Helpdesk (no relation!), and a network engineer who works from 5 AM until 1 PM, Norbert Network. In addition, the CEO has said that Sally can use Iggy Intern for four hours a week.

Sally gets her TaskJuggler file started:

project sysadvent "Sysadvent, Inc. Move" 2013-01-01 +3m {
    timezone "America/New_York"
}

# People: our greatest asset
resource sally "Sally Sysadmin" { }
resource harry "Harry Helpdesk" { }
resource henrietta "Henrietta Helpdesk" { }
resource norbert "Norbert Network" {
    workinghours mon-fri 05:00-13:00
}
resource iggy "Iggy Intern" {
    # Leave some time for Iggy to get Jordan's coffee
    limits { weeklymax 4h }
}

The project block defines attributes of the overall project. In this case the name, as well as a descriptive title, the start and end dates, and the time zone. Each person is defined with a resource element. Resources can have properties, for example the scheduling limit we set for Iggy or Norbert's unusual hours.

Now that the resources have been defined, Sally lays out the tasks that will need to be completed. She's careful to note the effort that each task will require and any dependencies that might exist. Sally also took advantage of this opportunity to buy new servers for the company.

task new_network "Setup network gear in the new site" {
    allocate norbert
    effort 3d
}
task pack "Pack things up" {
    task unused_workstations "Pack up unused workstations" {
        allocate iggy
        effort 8h
    }
    task spare_parts "Pack up spare parts" {
        allocate harry, henrietta, sally
        effort 2d
    }
    task printers "Pack up printers" {
    allocate iggy { alternative harry, henrietta }
        effort 2h
    }
    task workstations "Pack up workstations" {
        allocate sally, harry, henrietta, iggy
        depends !!install_new_servers
        effort 1d
    }
}
task rack_new_servers "Rack the new servers" {
    allocate iggy { alternative sally }
    effort 4h
}
task install_new_servers "Install the new servers" {
    allocate sally
    effort 2d
    depends new_network, rack_new_servers
}
task change_dns "Change DNS entries for external services" {
    allocate norbert
    effort 1h
    depends install_new_servers
}
task load_truck "Load the moving truck" {
    depends pack
    allocate sally, harry, henrietta, iggy
    effort 4h
}
task drive_truck "Drive the truck" {
    depends load_truck
    duration 1h
}
task unload_truck "Unload the moving truck" {
    depends drive_truck
    allocate sally, harry, henrietta, iggy
    effort 4h
}
task install_workstations "Install the workstations" {
    depends unload_truck, install_new_servers
    allocate sally, harry, henrietta, iggy
    effort 2d
}
task install_printers "Install the printers" {
    allocate harry, henrietta
    effort 2h
}
task put_away_spare_parts "Toss spare parts in the corner to be dealt with later" {
    allocate harry, henrietta, sally
    effort 2h
}

Tasks have an ID and a name. In order to schedule a task, TaskJuggler needs to know a start and and end date. These can either be explicitly given, or determined based on duration/effort and task dependencies. It's important to note the difference between effort, which is the amount of person-time it takes to complete a task, and duration, which is a wall time measure. A task which has effort defined must have one or more resources allocated. Although Iggy really wants to drive the moving truck, Sally thinks it's better to let the moving company do that, so she gave that task a duration.

Tasks can depend on one or more other tasks. The depends line refers to tasks in one of two ways: absolutely or relatively. Absolute paths start with the outermost task and contain the IDs of all intermediate tasks joined with periods. For example: pack.printers. Absolute paths use bangs to indicate how far up the tree to go. For example: to get to load_truck from pack, you would use !load_truck, but to get to load_truck from pack.printers, you would use !!load_truck.

Now that the project is well-defined, Sally wants to see the schedule. To do this, she defines a report.

# Make a Gantt chart
taskreport gantt "gantt_chart" {
    columns name, resources, start, end, chart { scale day }
    loadunit days
    formats html
}

Now Sally is all ready to schedule the project. She has already created a directory called "moving" in her web server's space, and she'll generate the HTML output there:

tj3 sysadvent.tjp -o /var/www/html/moving

Here's her schedule, simplified for easier blog viewing. Sally's first Gantt chart

Pleased with her work, Sally shows the boss. "That's nice," he says, "but I don't want to have to wait forever for Iggy to box up the unused workstations. Have Norbert help, but I don't want them working on it more than 6 hours per day." Sally goes back and adds norbert to the allocation for pack.unused_workstations and adds an additional line to that task:

limits { dailymax 6h }

This shortened the length of the project considerably.

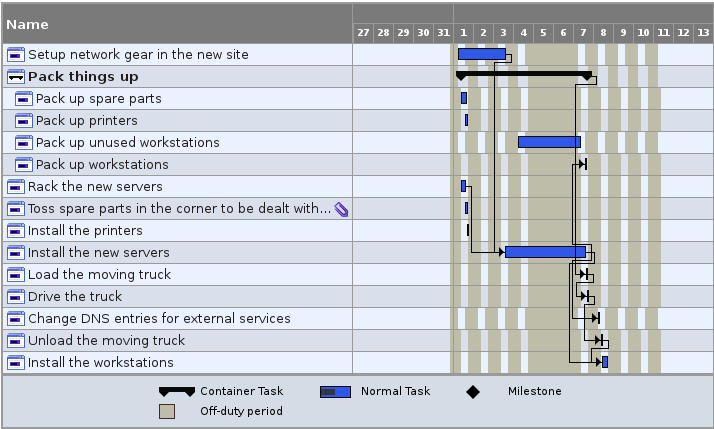

Sally's second Gantt chart

Sally's second Gantt chart

Sally presented the schedule to the rest of the team. Everyone was excited until Harry mentioned that he would be on vacation January 3-7. Oh! And the 1st is a holiday, and in this universe, the IT staff only ever work during normal business hours. First, Sally adds the holiday into the project. She inserts the following line above the resource definitions:

leaves holiday "New Year" 2013-01-01

Then she adds Harry's vacation to his resource definition:

resource harry "Harry Helpdesk" {
  vacation 2013-01-03 - 2013-01-07
}

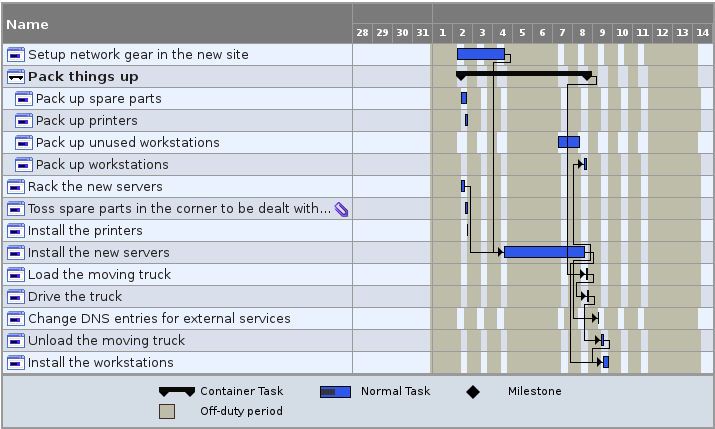

Finally, the project is scheduled. Sally's third Gantt chart

Everyone's happy with the schedule now, but it can be easy to overlook tasks. Sally decides to make a report for each person showing the tasks assigned to them. In order to be most efficient, she first creates a macro for the staff report:

# Generate reports for staff members
macro Staff_Report [
    taskreport "${1}" {
    headline "${1}'s tasks"
    columns name, effort, start, end, complete
    formats html
    hidetask ~(isdutyof(${1},plan) )
    }
]

Now she can generate a report for each staff member, showing only the tasks they are assigned to.

${Staff_Report "sally"}
${Staff_Report "harry"}
${Staff_Report "henrietta"}
${Staff_Report "norbert"}
${Staff_Report "iggy"}
Sally's task list

Sally's task list

As the project went along, Sally occasionally re-ran her project. She liked to see the completion bars grow. Because Sally is a perfect estimator, TaskJuggler was safe in assuming that everything was being completed exactly on time.

Conclusion

TaskJuggler is a popular tool for planning out projects. Bonus points that it is open source and has an active community.

The example above only shows a small set of this tool's features. For example, on the scheduling side, you can create multiple scenarios. TaskJuggler can keep track of leave information, track costs, even send and process timesheets.

For more information, see the TaskJuggler website. The final example taskjuggler file is available if you want take a peek.

Further Reading

No comments :
